“Ha Long Concert 2025” is the largest-scale art program ever organized by Quang Ninh province with about 30,000 spectators attending. Immediately after receiving the task, Quang Ninh Electricity Company assigned specialized departments to coordinate with the Ha Long Regional Electricity Management Team to strengthen the inspection and review of the entire power grid system in the area. Technical teams conducted detailed inspections, detected and promptly corrected defects, ensuring stable and safe operation of the power grid throughout the preparation and organization of the program.
The Ha Long Regional Power Management Team also closely coordinated with the Department of Culture, Sports and Tourism, the People's Committee of Ha Long Ward, and the event organizer to conduct a field survey at the 30/10 Square area - the location of the concert. Based on the capacity of the sound system, lighting, stage, LED screen and other technical equipment, the unit has developed a suitable power supply plan, meeting the highest safety standards.
Mr. Nguyen Van Thang, Deputy Head of the Ha Long Regional Power Management Team, said: Through review and calculation, the entire event has a need to use about 700kVA. This is also the event with the largest scale and load ever, increasing about 30% of the load compared to previous events in the province. In order to ensure absolute safety for the event, the unit has come up with the most optimal plan by arranging 3 independent power sources, including: 1 source from the grid; 2 sources from the backup generator system, combined with the uninterruptible power system (UBS) and automatic power transfer cabinet (ATS). Thereby, ensuring that the event is designed with a 4-level power backup system, which is also the most modern and highest level backup system ever. This will help ensure that 100% of any electrical problems that occur are resolved immediately, helping the program not to be interrupted.

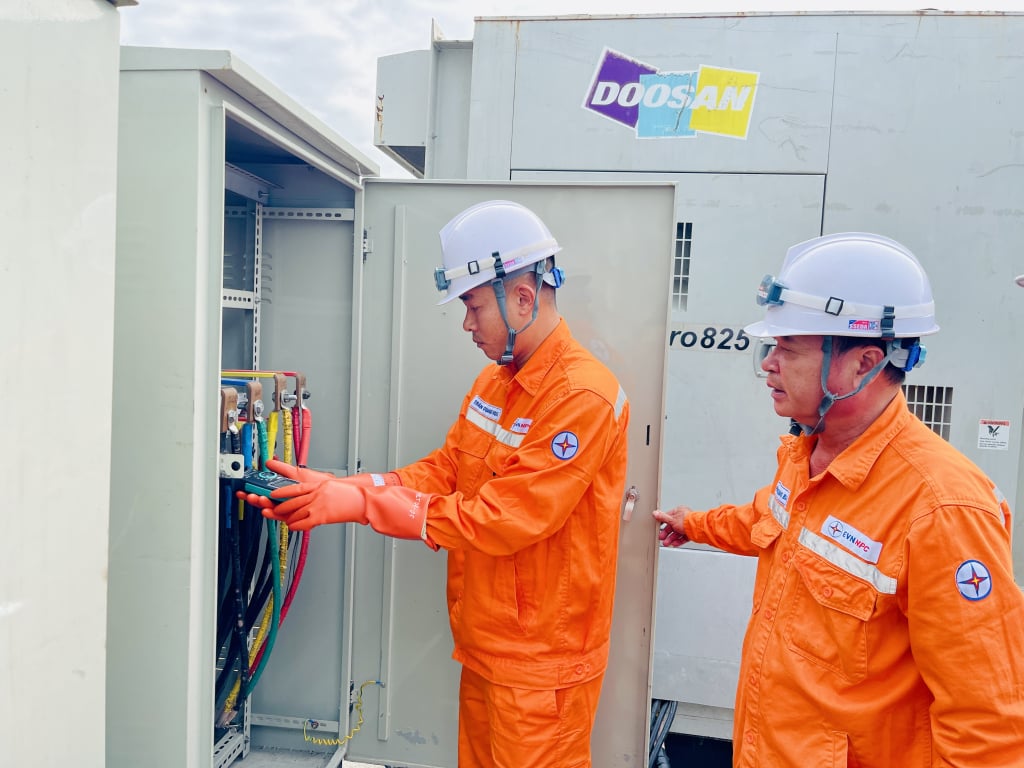

By the end of October 26, the Ha Long Regional Power Management Team had constructed more than 1,000m of 0.4kV cable, installed 4 low-voltage cabinets to serve the construction, practice, preliminary review, final rehearsal and official program. In addition, the unit also installed 3 large capacity generators (2 1,000kVA and 1 825kVA); UBS cabinet system, ATS power conversion cabinet system...
On the afternoon of October 27, the units tested the equipment according to operating methods before accepting the project into operation to supply electricity for the "Ha Long Concert 2025" program.
Particularly on the day of the event, to ensure absolute safety and smooth operation during the program, the Ha Long Regional Power Management Team will mobilize 100% of its staff, including groups on duty at the 30/10 Square area, groups on duty at power transfer points and mobile patrol groups, ready with all plans to handle any abnormalities that may occur on the power grid.
Source: https://baoquangninh.vn/dam-bao-cap-dien-an-toan-lien-tuc-cho-chuong-trinh-ha-long-concert-2025-3381917.html
